USS Gerald R. Ford enters Norfolk Naval Shipyard for first maintenance period after historic deployment.


The aircraft carrier USS Gerald R. Ford (CVN-78) entered Norfolk Naval Shipyard in Portsmouth, Virginia, on July 7, 2026, to begin its first scheduled Planned Incremental Availability (PIA) at a public shipyard. The maintenance period is designed to restore the carrier’s material condition and transition it to the Navy’s modern maintenance continuum following a demanding 326-day deployment. Shipyard personnel will conduct depot-level machinery repairs, structural modernization, and essential system overhauls while resolving unique first-of-class engineering requirements.

The USS Gerald R. Ford returned from an 11-month deployment during which the crew logged 57,713 nautical miles and completed 12,200 aircraft launches under multiple fleet taskings. The upcoming public shipyard availability will integrate routine depot inspections with permanent structural and electrical repairs to rectify damage caused by an onboard laundry fire in March 2026.

Related topic: US Navy requests $4.2 Billion to accelerate USS William J. Clinton Ford-class carrier procurement

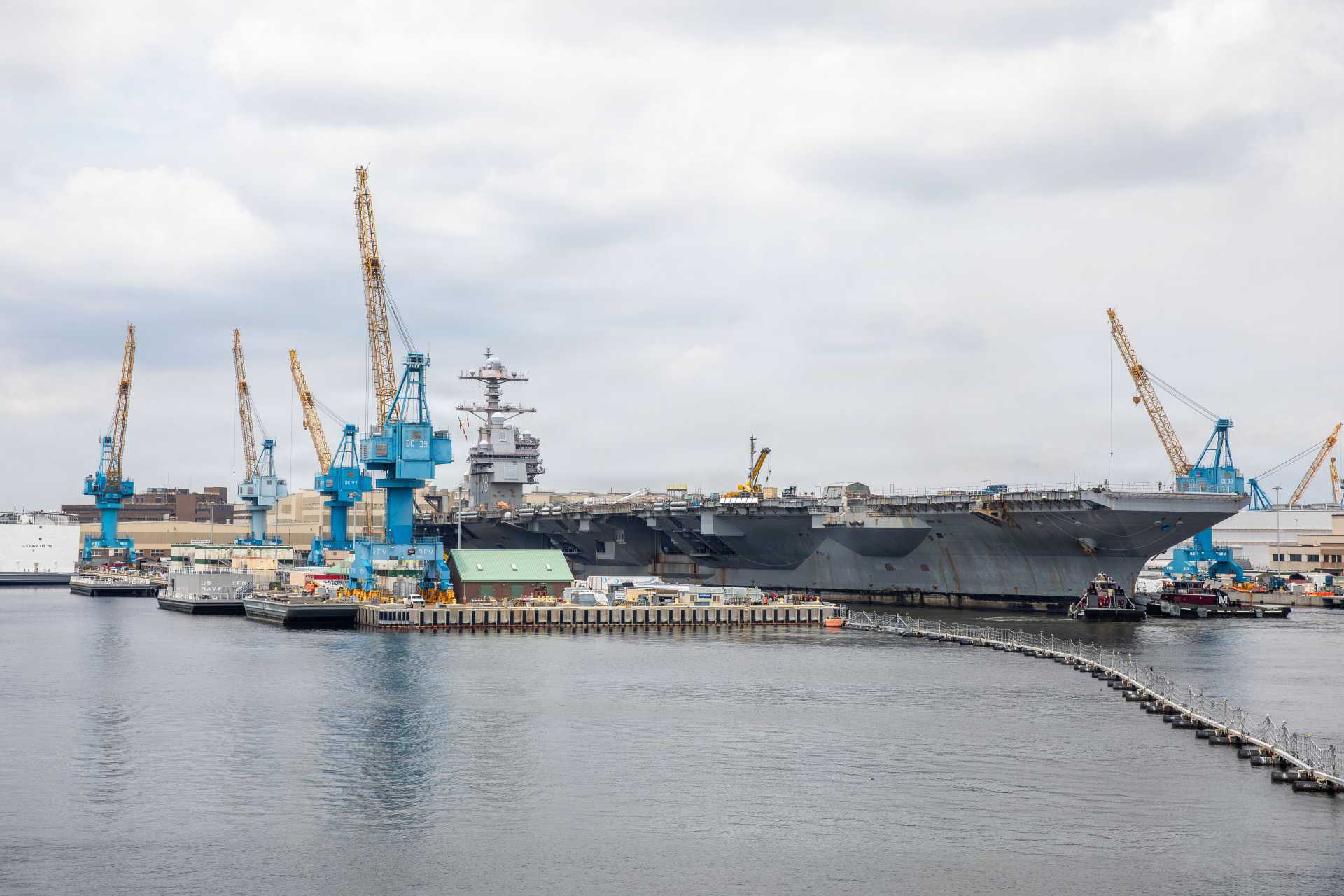

The USS Gerald R. Ford entered Norfolk Naval Shipyard only 52 days after returning to Naval Station Norfolk on May 16, 2026, at the end of a 326-day deployment that began on June 24, 2025. (Picture source: US Navy)

The USS Gerald R. Ford entered Norfolk Naval Shipyard only 52 days after returning to Naval Station Norfolk on May 16, 2026, at the end of a 326-day deployment that began on June 24, 2025. (Picture source: US Navy)


On July 7, 2026, the US Navy announced that the USS Gerald R. Ford (CVN-78) entered Norfolk Naval Shipyard in Portsmouth, Virginia, for its first regularly scheduled Planned Incremental Availability (PIA) at a public shipyard and the first Ford-class carrier maintenance period ever assigned to Norfolk. The ship entered the yard 52 days after returning to Naval Station Norfolk on May 16, following a 326-day deployment that began on June 24, 2025. During that deployment, the USS Gerald R. Ford crossed the Atlantic four times, operated in the North Sea, Mediterranean Sea, Caribbean Sea and Red Sea, and came under U.S. 2nd, 4th, 5th and 6th Fleet tasking.

The PIA will combine depot-level inspections, machinery repairs, electrical work, aviation system maintenance, modernization, habitability restoration and permanent repair of spaces damaged by the March 2026 fire. The central issue is schedule control, as Norfolk must absorb first-of-class work on a carrier with different reactors, electrical distribution, aircraft-launch equipment, arresting systems and weapons elevators from the Nimitz-class, while avoiding the 12 to 15 month durations recorded during the two most recent carrier PIAs completed at the yard. The starting condition of the USS Gerald R. Ford is more demanding than that of a carrier entering a routine post-deployment maintenance period.

The Ford remained deployed for 326 days, compared with 239 days away from homeport during its 2023 to 2024 deployment, and operated in four fleet areas across widely different climates. It participated in Neptune Strike 2025 in the High North, spent more than 100 days in the Caribbean and later returned across the Atlantic to conduct operations in the Red Sea. Four Atlantic crossings increased operating hours on main and auxiliary machinery, turbine generators, electrical switchboards, seawater systems, pumps, heat exchangers, valves and ventilation equipment. Flight operations increased cycles on the Electromagnetic Aircraft Launch System (EMALS), Advanced Arresting Gear (AAG), jet blast deflectors, deck-edge services, aircraft elevators and aviation fuel equipment.

The initial work must therefore account not only for elapsed time at sea, but for machinery hours, launch-and-recovery cycles, electrical loading, corrosion exposure and the reduced opportunity to complete depot work during an extended deployment. The principal schedule risk is that inspections will identify additional work after machinery, cables, ventilation trunks and enclosed spaces are opened. The March 2026 fire created a second repair line inside the broader PIA. The fire began in an aft laundry area and spread into nearby berthing compartments, destroying more than 100 racks and displacing sailors from normal sleeping spaces. The US Navy transferred about 1,000 mattresses from PCU John F. Kennedy (CVN-79) to restore temporary berthing capacity.



Norfolk Naval Shipyard sent 43 personnel to the carrier while it was in the Mediterranean, where they established temporary ventilation and lighting, restored temporary power, and repaired 440-volt cabling supporting combat system spaces in the aft section of the ship. That team completed the temporary work over five days at sea, allowing the Ford to continue the deployment and later resume operations in the Red Sea. The current availability must now remove temporary electrical arrangements, replace damaged cable runs, inspect bulkheads and overheads, assess heat and smoke effects on insulation and ventilation systems, restore permanent lighting and power, and rebuild berthing spaces. Firefighting water, combustion residue and smoke can also damage equipment outside the visibly burned area, so the final repair burden will depend on inspections behind panels, under deck coverings and inside cableways and ventilation trunks.

Moreover, the Carrier Air Wing 8 and the strike group’s deployment profile help illustrate how intensively the ship was used during its time at sea. The air wing included 36 F/A-18E Super Hornets, 12 F/A-18F Super Hornets, 5 EA-18G Growlers, 4 E-2D Advanced Hawkeyes, 2 C-2A Greyhounds, 10 MH-60R Seahawks and 8 MH-60S Seahawks. The escort force included USS Winston S. Churchill (DDG-81), USS Mitscher (DDG-57), USS Mahan (DDG-72), USS Bainbridge (DDG-96) and USS Forrest Sherman (DDG-98), although the five destroyers did not remain with the carrier for identical periods. Every aircraft launch and recovery added operating cycles to EMALS and Advanced Arresting Gear. At the same time, sustained deck operations increased wear on jet blast deflectors, catapult troughs, deck-edge electrical connections, aircraft elevators and aviation-fuel systems.

The air wing’s mix also imposed continuous demand on power generation, cooling, maintenance shops, weapons movement and data networks. For the shipyard, the relevant question is not the nominal number of days deployed, but how many major components have reached inspection thresholds, how many have exceeded expected operating hours and how much deferred work remained when the carrier returned to Norfolk. The USS Gerald R. Ford's Planned Incremental Availability (PIA) is therefore intended to restore material condition without removing the carrier from service for the duration of a docking period or a mid-life Refueling and Complex Overhaul. A PIA is conducted with the ship afloat and normally includes depot-level machinery work, electrical repairs, corrosion control, combat system alterations, aviation equipment maintenance and habitability improvements.

It does not provide the same access to the underwater hull, shafts, propellers, rudders and sea valves as a Docking Planned Incremental Availability. It also does not include reactor refueling or the structural reconstruction associated with an RCOH, which normally occurs once during a carrier’s service life and lasts several years. The US Navy’s maintenance-continuum concept attempts to divide work into smaller and more frequent periods rather than allowing it to accumulate into larger packages. Under the 32-month, one-deployment carrier cycle examined in prior fleet planning, a ship spent 19 % of the cycle deployed, 24 % in depot maintenance, 46 % able to surge within 30 days, and 11 % able to respond within 30 to 90 days. An 18-month cycle increased deployment time to 31 % but also raised depot maintenance to 36 % and reduced 30-day surge availability to 15 %.



A 42-month cycle with two deployments increased deployed time to 29 % and reduced maintenance to 18 %, but risked concentrating up to 375,000 labor-days into a single package, more than twice the workload public yards could efficiently complete within a six-month period. Norfolk Naval Shipyard’s recent carrier performance shows why the published completion date alone will not be sufficient to judge the Ford availability. The USS George H.W. Bush (CVN-77) entered PIA in November 2023 and completed the work in November 2024, requiring about 12 months. The USS Dwight D. Eisenhower (CVN-69) entered PIA in January 2025 and completed it in April 2026, requiring more than 15 months and more than 4,000 personnel at peak workforce loading. Both ships finished ahead of revised internal schedules, but both remained unavailable substantially longer than the traditional six-to-eight-month PIA planning range.

For fleet planning, an early finish against an extended yard schedule still represents additional months without a deployable carrier. The Ford adds a new coordination burden because Newport News Shipbuilding remains the Ford-class planning yard and retains the deepest design and construction knowledge, while Norfolk is responsible for physical execution. Norfolk personnel have received Ford-specific training at the Virginia Advanced Shipbuilding and Carrier Integration Center, conducted quarterly planning reviews, and exchanged information with the John F. Kennedy team. The number of repair questions requiring Newport News engineering support, the time needed to resolve them, and the amount of rework generated by incomplete configuration data will directly affect schedule performance.

The project team is attempting to protect the critical path by dividing work among pre-availability, central-availability and post-availability periods. Advance work at Naval Station Norfolk included early testing, preparations for temporary-service installation and jet blast deflector overhaul before Ford entered the yard. The shipyard is also applying its Focus and Finish model, intended to reduce multitasking, concentrate labor on active jobs and close work areas before moving personnel to new tasks. Late-discovered work that threatens the scheduled delivery date may be transferred into a post-Window of Opportunity period rather than inserted into the central PIA. That method can reduce schedule disruption, but it can also create a gap between physical departure from the yard and actual restoration of operational readiness.

Deferred work should therefore be measured by labor hours, safety significance, system affected, and planned completion date. Tasks involving electrical reliability, aviation operations, damage control, combat systems, weapons movement, nuclear-support equipment or crew habitability should be separated from low-priority cosmetic repairs and non-critical alterations. The decisive comparison is between the original work-package volume, the amount of new work added during inspections, the amount removed from the critical path, and the maintenance still incomplete when the ship begins sea trials. The maintenance burden is concentrated in systems that remain unique to the Ford-class.



The USS Gerald R. Ford (CVN-78) displaces about 100,000 tonnes at full load, measures 337 meters in length, has a 41-meter waterline beam, a 78-meter flight-deck width, and a draft of about 12 meters. The ship can carry more than 75 aircraft and embarks about 4,500 personnel with the air wing. Two A1B pressurized-water reactors drive four shafts and provide substantially more electrical capacity than the A4W plants installed in Nimitz-class carriers. That additional power supports four EMALS catapults, Advanced Arresting Gear, 11 advanced weapons elevators, electrically intensive sensors and a redesigned distribution system. However, while the EMALS was designed for an average of 4,166 launches between operational mission failures, early testing produced much lower reliability.

The weapons elevators also required years of corrective work after the ship’s 2017 delivery. The current PIA will provide the first public-yard data on removal times, inspection hours, component wear, spare-parts demand, software-diagnostic requirements and specialized labor after a 326-day deployment. The fleet-level result will depend on the date Ford returns to deployable status, not simply the date it leaves Norfolk Naval Shipyard. The U.S. Navy operates 11 aircraft carriers, but several are normally unavailable because of PIAs, docking periods, refueling overhauls, training or certification.

A six-month extension on one carrier therefore removes 9.1 percent of the total carrier inventory from the planning pool for an additional half-year, even before accounting for ships already unavailable for other reasons. The Navy should track total labor-days, monthly workforce loading, growth in unplanned work, material shortages, jobs completed by their scheduled finish dates, test failures, rework, deferred-maintenance volume, and the interval between yard departure and operational certification.

Ford-specific measures should include the number of engineering dispositions requested from Newport News, the average response time, the share of work performed by Norfolk personnel, private-yard employees, contractors and ship’s force, and the number of tasks moved into the post-availability period. Follow-on milestones should include sea trials, flight-deck certification, air-wing embarkation, combat-system certification, completion of basic training and restoration of 30-day surge status. Those metrics will shape the US Navy's planning for John F. Kennedy, Enterprise (CVN-80) and Doris Miller (CVN-81), including workforce training, spare parts stocks, planning yard support and the timing of future Ford-class availabilities.
