Breaking News
US Air Force launches North Star Readiness Campaign to stop escalating B-52 and B-1 bomber sustainment crisis.
On September 8, 2026, the U.S. Air Force Global Strike Command launched the North Star Readiness Campaign alongside Air Force Materiel Command and the Defense Logistics Agency to address mission-capable shortfalls across its 76 B-52H and 45 B-1B strategic bombers. The joint enterprise initiative directly targets supply chain bottlenecks, depot delays, and parts shortages to accelerate flight-line availability while legacy fleets undergo heavy modernization. By reforming cross-organizational logistics, lateral shipping times have already been reduced from seven-plus days down to 48-72 hours, cutting mission-impairing supply backlogs by over 64 percent.
The North Star Readiness Campaign has reduced high-priority MICAP supply cases from over 450 to approximately 160, accelerating parts delivery timelines across the strategic bomber fleet.
Related topic: First B-52J bomber flight approaches as US Air Force completes Rolls-Royce F130 engine review

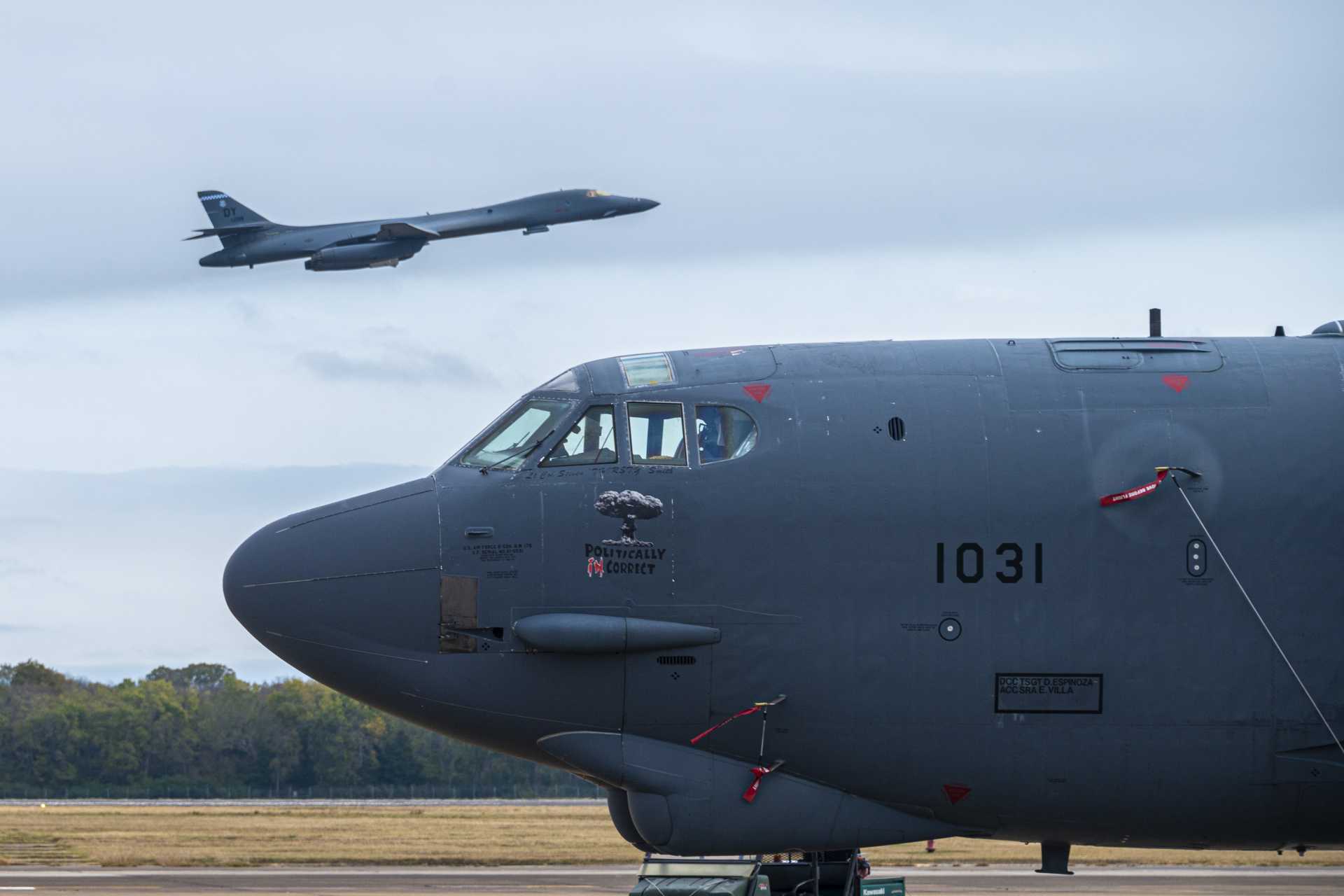

The B-52H and B-1B fleets remain at low readiness levels, with FY2024 mission-capable rates of 54% and 43%, respectively, mathematically equivalent to about 41 of 76 B-52Hs and 19 of 45 B-1Bs available for at least one assigned mission on average. (Picture source: US Air Force)
On September 8, 2026, the U.S. Air Force Global Strike Command (AFGSC) announced the North Star Readiness Campaign with the Air Force Materiel Command (AFMC) and the Defense Logistics Agency (DLA) to increase the number of mission-capable B-52H and B-1B strategic bombers by reducing parts shortages, aircraft-on-ground time, and depot delays. The latest public rates date back to FY2024, when the B-52H mission-capable rate was 54% and the B-1B rate 43%, down from 59% and 55% in FY2022. Applied to inventories of 76 B-52Hs and 45 B-1Bs, FY2024 rates mathematically equal 41 and 19 mission-capable aircraft, or 60 of 121 bombers, although these annual averages are not daily combat-available counts. North Star has reduced mission-impairing capability awaiting parts (MICAP) cases from more than 450 to about 160, eliminating at least 290 cases and more than 64% of the previous backlog.
The U.S. Air Force campaign, therefore, starts at the supply level, but the underlying readiness equation is broader: 45 aging B-1Bs require increasingly intensive structural work, while 76 B-52Hs must remain operational into the 2050s while absorbing 13 concurrent modernization programs costing nearly $21 billion. The North Star Readiness Campaign's immediate objective is to shorten the interval between identifying a failure and returning an aircraft to service. AFGSC flight-line maintainers and operators are working directly with AFMC, DLA, supply chain organizations, logistics readiness squadrons, depot personnel, engineering organizations, and commercial contractors rather than allowing individual shortages to move sequentially through separate organizations.
Lateral shipments that previously required seven days or more can now reach operating units in two to three days, reducing transportation times from at least 168 hours to 48-72 hours, a cut of 57 to 71%. MICAP volume has simultaneously fallen from more than 450 cases to about 160, meaning fewer than 36 cases now remain for every 100 present at the campaign's earlier baseline. This lower workload allows personnel to move beyond immediate aircraft-on-ground cases and address high-priority backorders and components showing recurring failure patterns before they generate additional groundings. Flight-line personnel have also developed a localized phase-maintenance playbook that shortened maintenance timelines, although no quantified reduction has been released. No post-North Star mission-capable rate is available, so the campaign cannot yet be credited with increasing the B-52H above 54% or the B-1B above 43%.
For the B-1B fleet, a 43% FY2024 mission-capable rate against 45 aircraft mathematically corresponds to 19.35 aircraft, compared with 24.75 aircraft if the same fleet had retained its 55% FY2022 rate. The 12-point deterioration therefore represents a mathematical difference equivalent to 5.4 aircraft across the annual average, potentially illustrating the scale of the readiness decline even though these figures are not daily fleet counts. The causes extend beyond missing consumables. Aircraft Structural Integrity Program (ASIP) inspections and Forward Intermediate Fuselage Replacement (FIFR) address structural deterioration requiring lengthy aircraft downtime, while declining reliability and spare part availability increase Total Non-Mission Capable for Supply. Higher TNMCS drives cannibalization, in which maintainers remove usable components from one B-1B to restore another, shifting the shortage between tail numbers rather than creating another serviceable component.
Diminishing manufacturing sources, fewer qualified vendors, and long repair lead times restrict replacement throughput. The B-1 Embracing Agile Scheduling Team (BEAST) addresses structural sustainment alongside IFF upgrades, secure communications, defensive system changes, simulator modernization, and digital-twin applications. North Star consequently attacks the time lost between failure, supply action, and repair, while BEAST and structural programs address causes that cannot be eliminated through faster component movement alone. The B-52 supply chain has a different scale: 76 remaining B-52Hs, representing only 10.2% of the 744 B-52s originally produced, depend on roughly 76,000 distinct spare part types, equivalent to about 1,000 part types for every aircraft remaining in inventory. The last B-52H was delivered in 1962, creating a 64-year interval between final delivery and North Star's launch in 2026.
Unplanned depot findings can leave an aircraft waiting 80 to 100 days at Tinker Air Force Base specifically for replacement parts, equivalent to 24 to 29% of the FY2025 average 340-day depot cycle. Engine logistics are particularly restrictive because the legacy engines contain more than 6,000 unique parts and many manufacturing sources no longer exist, forcing maintainers to cannibalize other B-52 engines. A 2017 Air Force assessment determined that continued engine sustainment would become unsustainable after FY2030 without replacement due to obsolescence and insufficient manufacturing capacity. Establishing production for a newly manufactured B-52 component requires a minimum of two years, so a shortage identified in 2026 may not be resolved before 2028, even before additional delays associated with re-establishing tooling or qualifying a supplier.
With only 76 aircraft, low-volume demand further limits the commercial case for maintaining dedicated production capacity. This supply problem has already translated directly into longer depot cycles. Average B-52 depot flow increased from 219 days in FY2020 to 340 days in FY2025 (55.3%); this means a B-52 in FY2025 occupied a depot capacity for almost four additional months compared with FY2020. Unexpected wing corrosion, discovered in FY2022, added another average penalty of about 58 days per affected depot cycle, equivalent to 17.1% of the current 340-day average. Each B-52 generally enters programmed depot maintenance once every four years and requires about 40,000 labor hours before modernization work is added. With a planned throughput of 17 aircraft annually, cycling 76 aircraft through the depot mathematically requires 4.5 years.
The modernization plan requires average depot flow to fall from the FY2025 level of 340 days to 301 days, a 39-day or 11.5% reduction. If replacement engines arrive late, however, continued work on the increasingly difficult legacy engines could push depot flow more than 50% above that target, exceeding 452 days per aircraft. The difficulty is that this depot workload is scheduled to increase at the same time the U.S. Air Force needs depot flow to decrease. As of March 2026, the B-52 portfolio contained 13 modernization programs, of which 10 had cost, schedule, or performance problems: three had experienced cost growth, seven were behind schedule, and eight had performance problems, with three affected in all three categories.
The Commercial Engine Replacement Program (CEPR) adds 23,345 hours; the Radar Modernization Program (RMP) another 10,000 to 15,000; the Advanced Extremely High Frequency (AEHF) 5,000; the Crypto/MUOS 5,000; the Tactical Data Link 935; the Quad Crew about 900; the Military Code about 900, the VLF/LF 420; the Mission Data Recorder 220; and the VINSON cryptographic modernization 10. Using the 15,000-hour upper estimate for RMP, those modifications total roughly 51,730 additional installation hours per aircraft, equal to 129% of the labor required for an ordinary 40,000-hour depot-maintenance package. For 17 aircraft, that would mathematically represent about 1.56 million labor hours if all listed work were concentrated in the same annual cohort, compared with 680,000 hours for baseline depot maintenance alone.
Tinker capacity analysis found that the depot could not maintain the planned 17-aircraft annual throughput and install CERP simultaneously with existing resources, leaving three basic options: reduce annual completions, reduce modification work, or add personnel, parts and facilities. CERP and RMP also concentrate the financial exposure. Together they account for about $18.3 billion of nearly $21 billion in B-52 modernization acquisition costs (88%), leaving less than $2.7 billion for the other 11 programs combined. CERP alone increased more than 38% from its 2018 estimate to over $15.4 billion in 2025, and its planned development start moved 32 months from FY2023 Q4 to FY2026 Q3. Developmental flight testing shifted to FY2029 Q1, four years later than previously planned, while initial operational capability moved to 2033, nearly five years later.
For instance, a June 2023 wind-tunnel test found an inlet-flow distortion capable of causing an in-flight engine fan stall; the verification of the redesigned inlet was only completed in June 2025. For its part, the RMP increased by more than 30% to over $2.9 billion; production slipped by more than two years to FY2026 Q3; IOC moved about 3.5 years to FY2030 Q3, and performance requirements were reduced from 25 to 20, a 20% reduction. After a significant Nunn-McCurdy breach in May 2025, RMP is scheduled to begin production after only two months of an 18-month developmental flight-test period, leaving 16 months, or 88.9% of planned developmental flight testing, to occur after production has begun.
The constraint extends to the equipment and infrastructure needed to turn parts and labor into completed aircraft. As of July 2025, the B-52 enterprise possessed 72% of authorized common support equipment, leaving a 28% deficit, and 63% of B-52-specific equipment, leaving a 37% deficit. When Tinker's jet analyzer used to verify repaired-engine speed and thrust failed, no local spare was available, and another analyzer had to be borrowed to prevent engine testing from stopping. Tinker originally had six B-52 hangar bays, but two were internal "locked-in" positions, so aircraft in those bays could remain unable to exit for days or weeks until another B-52 was moved.
A temporary two-bay facility increased usable flow capacity, while a four-bay Agile Common Hangar is being accelerated toward construction beginning in FY2026 for CERP work from about FY2031, before later supporting the B-21. Supply measures include ordering parts years before aircraft induction, monthly prioritization of shortages, DLA incentives for low-volume suppliers, and limited in-house manufacturing such as left-hand engine cowls and partial engine rebuilds. Each partial rebuild saves about $4 million relative to a complete engine overhaul and consumes fewer scarce components, although the repaired engine returns with a shorter remaining service life.
